Tiny modular home plan approval and design: What happens first
State plan approval for a Wolf modular home, then the local permit. Gold Label or L&I insignia, Oregon and Washington expiration rules, and the design steps before submittal.
A small modular home starts with the same question as any building project: what will the property allow?
Picking a floor plan is the fun part. But nothing gets built until two approvals are in hand. The first is the state’s factory-plan approval for the design. The second is the local permit for your lot.
The state insignia, before your building permit

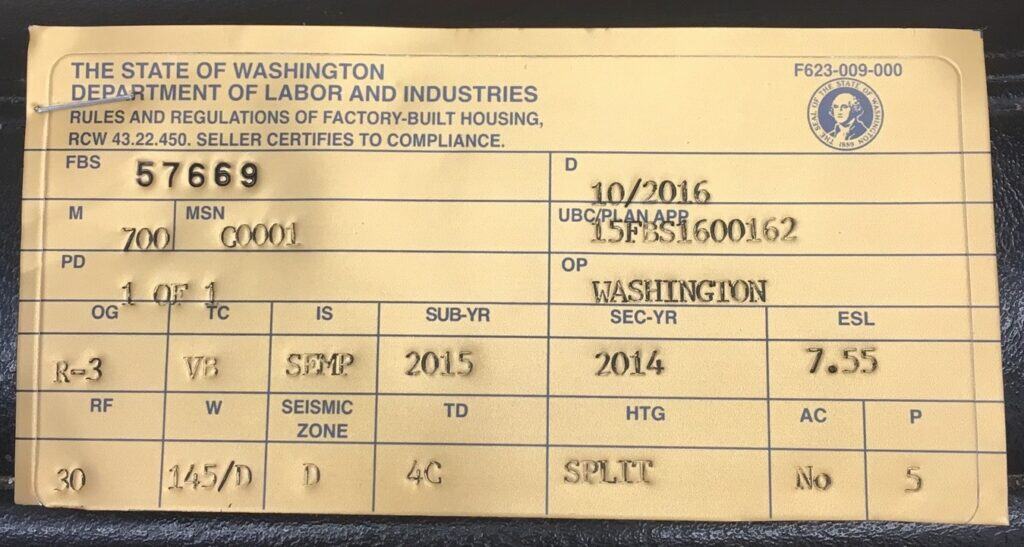

Every Wolf home leaves the factory with a state insignia. In the shop, we still call the Oregon version a Gold Label. It’s the Building Codes Division’s mark that the home was built to the statewide modular standards. Those are the same family of codes a site-built house uses. They include the National Electrical Code, the International Residential Code, and the International Building Code where it applies, plus the plumbing, mechanical, and energy codes. Washington’s version is the Labor & Industries insignia from the Factory Assembled Structures program. With that mark, a local building department can review the house as a dwelling.
The insignia doesn’t decide the use. Zoning still decides whether that dwelling can be the primary home, an ADU (accessory dwelling unit), or a guest house. A guest house sometimes needs a different layout or a different permit than an ADU. The label doesn’t override that.
A new design goes through the state before we can build it for that state:
- We sketch a floor plan around what customers keep asking for, then refine it. That refinement usually takes 2 to 3 weeks, and it’s where we redraw any code problems.
- A structural engineer draws the structural sheets. That step usually takes 3 to 4 weeks.
- Oregon and Washington want different submittal formats and fee schedules, and their codes differ in small ways. Pulling the packet together usually takes a day or two.
- A state plan examiner reviews it. Questions come back as a letter, and we answer and send revised sheets. Once the examiner signs off, we can build that design. State review usually takes 1 to 2 months.
A home bound for Oregon has to be built from a plan approved by the Oregon Building Codes Division Prefabricated Structures program. The BCD guide for local building departments is the handout those departments use. A home bound for Washington has to be built from a plan approved by Washington L&I, Factory Assembled Structures.
An approved plan has two limits. First, the home can only go where the design criteria meet or beat what the site needs. Snow load is the usual one, which is why we draw the plans to a high load for the state they’re approved in. Second, the approval expires. In Oregon, an approved plan expires one year after approval. In Washington, it expires at the end of the code cycle. The I-codes run on a three-year cycle, so a new edition means the plan has to be renewed. Keeping our model list short spreads that review cost across the homes we actually build.
Your local permit is a separate packet, and the steps below cover it. The insignia covers the home itself. The city or county still reviews zoning, the foundation, utilities, and occupancy. The state approval has to be in place for the model before the city or county can permit the installation.
Step one: property evaluation
Before design work gets serious, we look at the lot. The model has to fit the rules and the physical site.
It starts with a free property evaluation, which is a first look at zoning, setbacks, and what’s generally allowed on your lot. As the project moves forward, we take a closer look at the site itself. Together, those steps cover:
- Setbacks and lot coverage.
- Access for delivery and set equipment.
- Existing structures, trees, slopes, and driveways.
- Water, sewer or septic, power, and gas.
- Jurisdiction and likely permit path.
- Whether the home is an ADU (accessory dwelling unit), a primary dwelling, a guest house, or another allowed use.
Doing this first keeps you from paying for a plan that can’t be permitted or delivered.
Step two: model fit
Wolf models range from compact one-bedroom homes to larger two- and three-bedroom layouts. The right starting point depends on your goal and your lot.
A narrow backyard may point toward the Model K, or the Model B inside the City of Portland. A family unit may need the Model E, F, J, L, or I. A rental project may favor the smallest plan that still feels complete.
Step three: selections and site-specific details
Once the model looks realistic, the details come into focus. Roof style, orientation, a mirrored layout, the utility approach, foundation, porch, appliance package, and finish selections all affect the plan set and project cost.
Delivery planning matters here, too. The route into the site and the way you’ll use the home can both affect where the doors go and which way the home faces.
Step four: permit documents
The permit package is what gets filed with your city or county. Depending on the project, it can include drawings, a site plan, utility notes, engineering details, energy information, and corrections the reviewer asks for.
Our permit team handles this work in-house. We submit the package, track comments, answer corrections, and keep the project moving through the local review cycle. Final approval still depends on your jurisdiction.
Step five: approval, production, and set
Permitting is usually the longest part of the timeline. Once approval is in hand, the home can move through the factory, usually in weeks rather than months. We plan site work and delivery alongside production, so the foundation and utilities are ready on set day. That’s the day the home is placed on its foundation. After the set, we connect the home, get it inspected, and walk through it with you.
